Projects

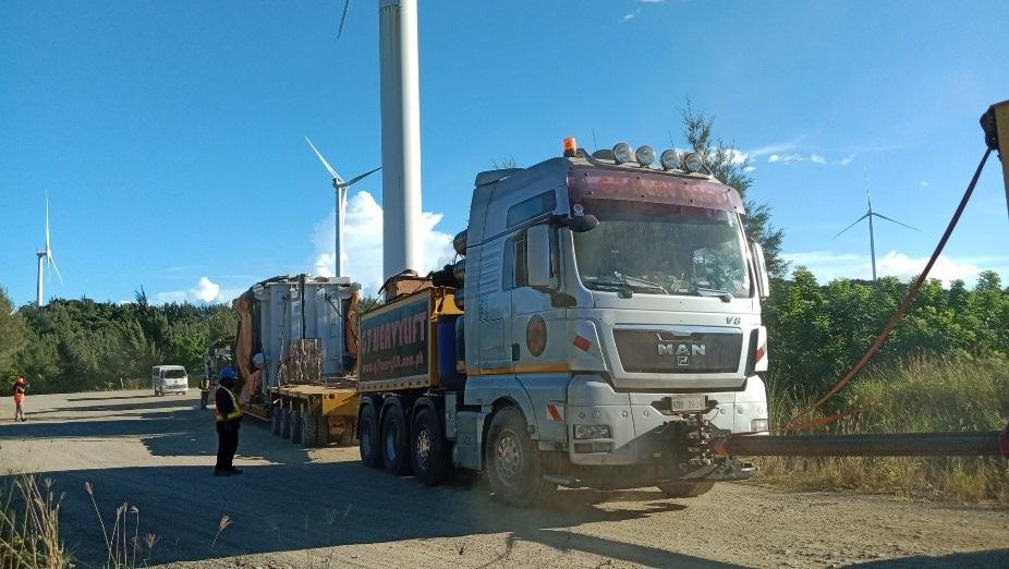

October 1 – 7, 2022 MIESCOR - HANDLING OF ONE (1) UNIT 109 MT TRANSFORMER FOR BWPC WINDFARM

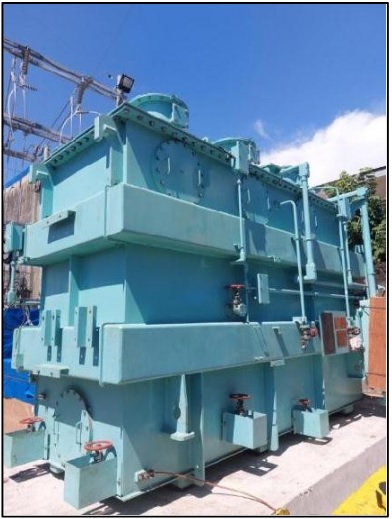

G7 handled transport of One (1) Unit Transformer Main Body weighing 109 MT, from Cargo receiving to foreign vessel, roll-on to barge, sea transport Manila to Caparispisan, Pagudpud Ilocos Norte, transport/pass thru from Caparispisan / Ayoyo Trail to Caunayan Middle Ridge to Foundation the (Challenge of the project) then unloading of transformer via Manual Jacking/skidding at site's foundation.
L- 8.1 x W- 3.28 x H- 4.09 = 109 MT

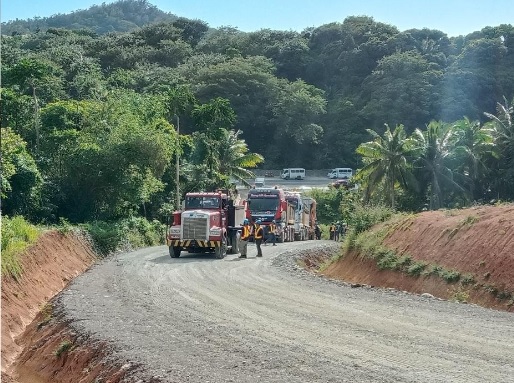

2ND most critical part: Passing thru Ayoyo Ridge and Caunayan Middle Ridge, it requires more tractor/prime mover to ensure safe transport

SEA TRANSPORT
TRANSPORT FROM CAPARISPISAN JETTY TO SITE
UNLOADING/SPOTTING VIA MANUAL JACKING/SKIDDING
HAULING/ TRANSPORT








UNLOADING SPOTTING

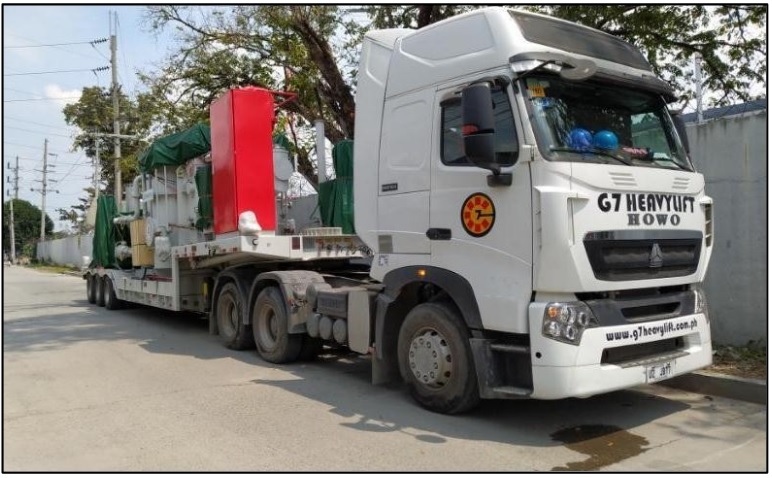

March 10-16, 2022 MIESCOR BUILDERS INC. - HANDLING OF ONE (1) UNIT 56 MT ABB TRANSFORMER
G7 handled transport of One (1) Unit Transformer Main Body weighing 65 MT, loading via Manual Jacking/skidding from Meralco Calumpit Substation to Meralco Ilo-ilo Substation
L- 6.5m x 2.83m x 3.7m Weighing 65 MT
- Mobilization to Meralco Calumpit
- Loading to trailer of transformer via manual jacking/skidding
- Transport roll on to suitable LCT/Barge, seafastening
- Roll off transport to Jobsite
- Unloading/spotting to foundation via manual jacking/skidding

LOADING TO TRAILER VIA MANUAL JACKING/SKIDDING
TRANSPORT FROM CALUMPIT, BULACAN TO ILO-ILO
UNLOADING/SPOTTING VIA MANUAL JACKING/SKIDDING
Nov. 10-16, 2021 BENLINE AGENCIES PHIL. INC. - HANDLING OF ONE (1) UNIT 173 MT ABB TRANSFORMER
G7 handled transport of One (1) Unit Transformer Main Body weighing 173 MT, Shipside cargo receiving from Harbour Centre Barging to Mauban, Quezon Power Plant.
L- 7.80 x W- 3.76 x H- 4.84 = 173 MT
- Barging to Mauban, Quezon Power Plant
- Roll-off transport to foundation area
Unload via Manual Jacking Skidding

SHIPSIDE CARGO RECEIVING OF 247MT ABB TRANSFORMER
ROLL-OFF TO PAGBILAO PLANT JETTY, TRANSPORT TO PROPOSED LAYDOWN AREA
UNLOADING VIA MANUAL JACKING
Feb 3 - March 2, 2020 CEBU LINK JOING VENTURE (CLJV)- LAUNCHING GIRDER PROJECT
G7 handled transport of One (1) Unit Transformer Main Body weighing 109 MT, from Cargo receiving to foreign vessel, roll-on to barge, sea transport Manila to Caparispisan, Pagudpud Ilocos Norte, transport/pass thru from Caparispisan / Ayoyo Trail to Caunayan Middle Ridge to Foundation the (Challenge of the project) then unloading of transformer via Manual Jacking/skidding at site's foundation.
L- 8.1 x W- 3.28 x H- 4.09 = 109 MT
2ND most critical part: Passing thru Ayoyo Ridge and Caunayan Middle Ridge, it requires more tractor/prime mover to ensure safe transport



November 6-9, 2021 BENLINE AGENCIES PHILIPPINES - MAKBAN GEOTHERMAL POWER PLANT PROJECT
G7 handled the replacement of old 68KVA power transformer by new 68KVA power transformer and hustling of both transformer from and to temporary laydown area.
2 Units of 2.3MVA 6T Transformer ( Old and New)
26 Pallets of Transformer Oils
Hustling of Old trafo to temporary storage area.

Hustling of Old trafo to TLA
Spotting/Positioning of New Trafo
Unloading/Spotting to Foundation
JUNE 14, 2020 - OCTOBER 31, 2020 BENLINE AGENCIES PHILIPPINES - MASINLOC POWER PLANT PROJECT
G7 handled the Direct Receiving, Hustling, Jacking and Delivery of One (1) Turbine Generator Set Composed with Four(4) Heavy Cargoes and its Accessories
One (1) Unit 40 MT LP Lower Part 5.49x4.48x3.24m
One (1) Unit 29.5MT LP Upper Part - 5.56x4.36x3.84m
One (1) Unit 23MT Turbine Rotor Assembly 8.04x1.78x1.87m

Direct Receiving from Vessel
Hustling of Cargoes to Storage Area
Unloading/Hanging on Beams at Storage area
May 25 - June 1, 2021 FUJIAN- NGCP BANILAD S/S, CEBU PROJECT, TWO (2) UNITS TRANSFORMERS 113MT each
G7 most recent project for Fujian Electric Corp. Handling of 2 units transformer received at Cebu Port (CIP) & delivered to NGCP Banilad Substation, Cebu.
Heavy Cargo:
Two (2) Units Transformer, L- 10.65 x 3.85 x 3.6 Weighing 113 MT each.

TRANSPORT FROM CIP TO SITE
UNLOADING/SPOTTING TO FOUNDATION AREA

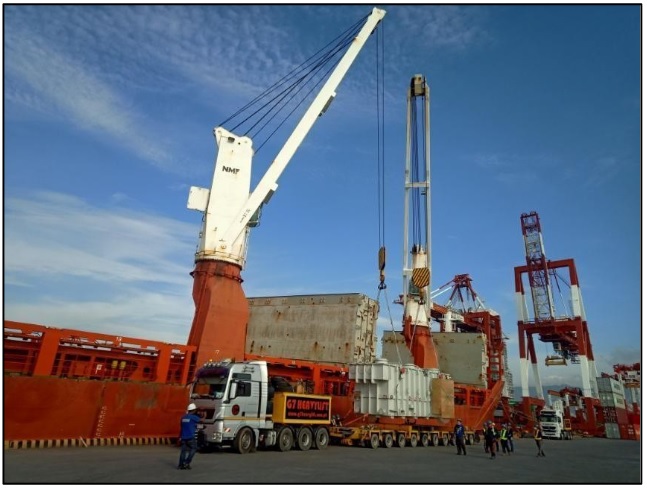

September 2019 ECU WORLDWIDE- HANDLING OF ONE (1) UNIT 247MT ABB TRANSFORMER (BODY)
G7 handled transport of One (1) Unit ABB Transformer Main Body weighing 247 MT, Shipside cargo receiving of cargo from Harbour Centre Barging to Pagbilao Team Energy.
L- 8.99 x W- 4.09 x H- 4.3 = 247 MT
- Barging to Pagbilao Team Energy Jetty
- Roll-off transport to foundation area
Jack-down/Unload trafo to foundation

SHIPSIDE CARGO RECEIVING OF 247MT ABB TRANSFORMER
ROLL-OFF TO PAGBILAO PLANT JETTY, TRANSPORT TO PROPOSED LAYDOWN AREA
UNLOADING VIA MANUAL JACKING
February - April 2020 SUPREME POWER CORP. - HANDLING OF WARTSILA ENGINE & GENERATORS
G7 handled transport of Three (3) Units Warsila and Generators fromSto. Tomas & Sta. Rosa, Laguna Warehouse to Mati, Davao. From Pull-out to Spotting to foundation of engines.
3 Units 18 MT, Hyundai Generators
6 Units 2.8 MT each, Fixing Rails
39 Packages total of 141.94 cbm

Hauling to Batangas Port
Transport/Steaming to Davao
Unloading/Spotting to Foundation
Sept. 29 - Oct. 15, 2020 DB SCHENKER- DELIVERY OF MOBILE TRANSFORMERS
G7 delivered of Three (3) Units, each Mobile Transformers from its destination. NGCP Mexico, Pampanga & NGCP Daraga, Albay
